Walk-In Freezer Installation

Low-temperature walk-in rooms place different demands on an installation because defrost, drain protection, insulation, and pull-down performance all affect whether the freezer can operate as intended. CooperFix connects those demands to the evaporator pictured inside the newly built enclosure. The work therefore concentrates on freezer-specific planning: matching the condensing unit and evaporator, protecting the drain path, setting appropriate control logic, and commissioning the room under low-temperature conditions rather than treating it as a colder version of a cooler.

Book Service Call 647-483-3777

Have This Ready

  • Room dimensions and target set point
  • Product type and daily loading
  • Where the condensing unit can sit
  • Available power supply
  • Drain route and floor condition

Inside a new freezer box

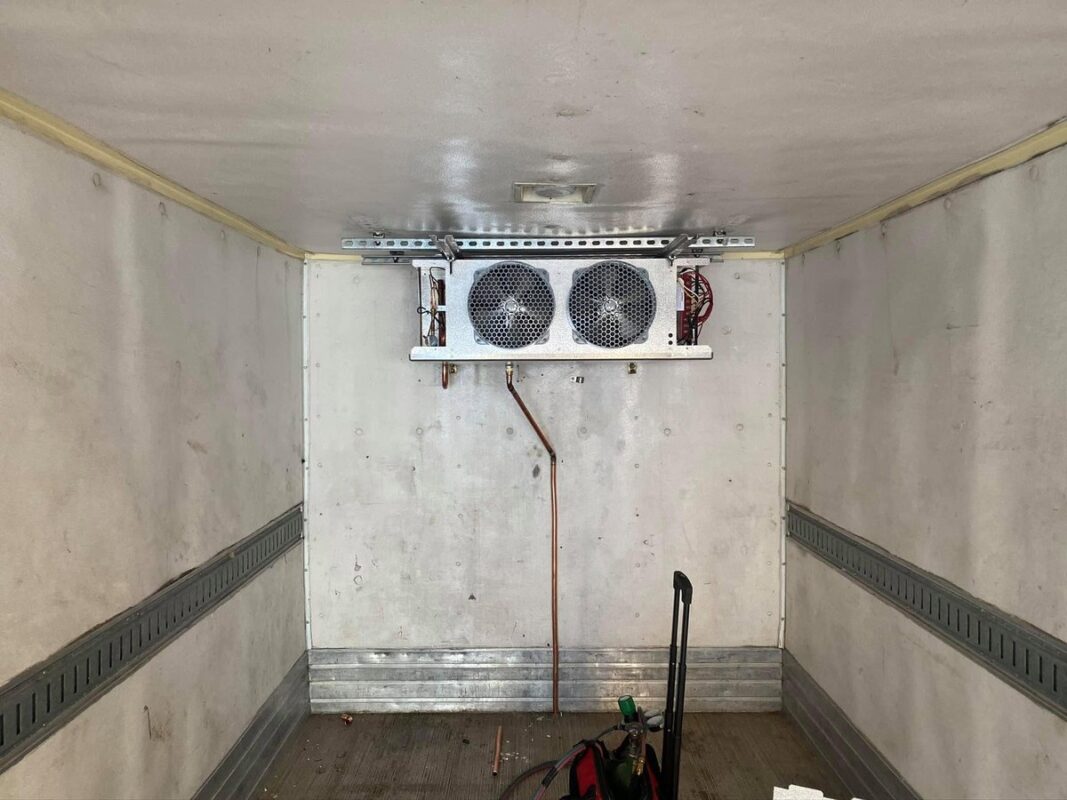

The interior of a newly built walk-in freezer before the shelving goes in. Insulation, floor detail, door heaters and coil placement are what decide whether the box holds its temperature in July. CooperFix sets the unit up and records the pull-down.

Interior of a newly built walk-in freezer

Interior of a newly built walk-in freezer.

24/7 EMERGENCY CALLS

Refrigeration down? Call us now.

Commercial refrigeration repair across Toronto and the GTA. Emergency calls are received and assessed around the clock.

  • Walk-in coolers & freezers
  • Reach-in fridges & freezers
  • Display cases
  • Beverage coolers
  • Prep & sandwich tables
  • Compressors, condensers, evaporators
  • Digital controllers & sensors
  • Defrost systems & electrical controls
(647) 483-3777
  • 24/7 Emergency Calls
  • Mechanic 313A
  • ODP/ODS Certified
  • Toronto & GTA

Request Service

Tell us the equipment and the problem — we will get back to you.

    Please prove you are human by selecting the tree.

    CooperFix services commercial refrigeration equipment only.

    What a Walk-In Freezer Installation Covers

    System Selection

    Capacity is matched to room volume, insulation, door traffic and product load rather than to a catalogue number. An undersized system never catches up; an oversized one short-cycles.

    Piping and Electrical

    Suction and liquid lines are routed and insulated for low-temperature duty. Electrical is connected to code and the controller is wired for defrost and alarm.

    Commissioning

    The room is pulled down, superheat and subcooling are measured, defrost timing is set and the finished readings are recorded before handover.

    Low Temperature Changes the Details

    • Defrost strategy has to be set for the room, not left at default
    • Drain lines need heat trace so condensate does not freeze in the pipe
    • Door heaters and sweeps matter more than in a cooler
    • Suction lines carry more insulation than a medium-temperature run
    • Pull-down is slower and has to be verified, not assumed

    What You Get on Handover

    A written record of the installed equipment, measured operating conditions, set point, defrost settings and any conditions found on site.

    If the room is part of a larger food service or production build, we coordinate the sequence with your contractor so the freezer is commissioned once and not disturbed afterwards.

    Who This Is For

    Restaurants, grocery and specialty retail, bakeries, butchers, caterers, commissaries, food production and institutional food service adding or replacing a low-temperature room in Toronto and the GTA.

    What Low Temperature Changes in the Design

    A freezer is not a colder cooler. Below freezing, four things that a cooler tolerates become design decisions, and getting any of them wrong produces a room that ices, heaves or never quite holds.

    • Defrost method and schedule. Electric or hot gas, how often, how long, and how termination is sensed. A schedule copied from a factory default rather than set for the room’s real moisture load is the most common source of chronic icing.
    • Vapour barrier continuity. Every penetration — lines, drains, conduit — is a path for moisture into the panel. Moisture inside a freezer panel is not repairable; it is replacement.
    • Doorway design. Heated frame, heated gasket, sweep, closer, and a strip curtain or vestibule. This is where nearly all the moisture that becomes coil ice actually enters.
    • Drain heating over the whole run. A freezer drain freezes at the first unheated section, not at the coil. The heater has to run the full length, including through the wall.
    • Head pressure control for winter. In this climate an outdoor low-temperature condensing unit without working low-ambient control cannot maintain enough head pressure to feed the expansion valve in January.

    Site Conditions That Decide the Quote

    Established before a price is given, because none of them can be discovered halfway through the job.

    • Floor construction: whether the box needs an insulated floor, under-floor heating, or a ramp and threshold
    • Where the condensing unit can go, the ambient it will see, and how lines are routed
    • Electrical supply: voltage, phase, capacity, distance to panel, and the extra circuits low temperature needs for defrost, door heaters and floor heating
    • Where the drain terminates, whether the full run can be heated and pitched, and how it passes through the wall
    • Access for the condensing unit and coil — door widths, corners, stairs, elevator dimensions
    • Ceiling height and clearance above the room for coil mounting and service access
    • What has to keep running during the work, and how product will be handled meanwhile

    Commissioning a Freezer, and What Gets Recorded

    A freezer that reaches -18°C on the day is not proof of anything. What matters is whether it holds through a full defrost cycle with a real load, and whether that was measured.

    1. Pressure test and evacuation before charging, with the evacuation held and verified rather than timed.
    2. Charge weighed in against the nameplate.
    3. Superheat and subcooling set and recorded at low-temperature operating conditions.
    4. Defrost schedule set for the real moisture load, then a full cycle run and the termination point recorded.
    5. Coil inspected after that defrost cycle to confirm it actually cleared.
    6. Door heaters, gasket seal, closer, sweep and any floor heating confirmed working.
    7. Drain run tested with water, heater confirmed over the whole length, trap and pitch verified.
    8. Pull-down from ambient recorded, and the recovery time after a door-open period recorded separately.
    9. Handover with all readings, settings, model and serial numbers written down as the baseline for future service.

    Frequently Asked Questions

    Why does a freezer need so many extra electrical circuits?

    Because defrost, door heaters and floor heating are all separate loads that a cooler does not have. Underestimating this is a common reason installations stall partway.

    Can a walk-in cooler be converted to a freezer?

    Sometimes, but rarely as a simple swap. Floor, vapour barrier, doorway heating, drain heating, coil selection and electrical capacity all have to be reassessed, and the honest answer is often that a conversion costs close to a new box.

    How long does installation take?

    It depends on panel delivery, access, electrical work and floor preparation. A realistic schedule is given after the site visit, with the parts that could move flagged.

    Do you service what you install?

    Yes, and the commissioning readings become the baseline for every later visit.

    Request a Walk-In Freezer Installation Quote

    Tell us the room size, the set point you need, where the condensing unit can go and your timeline.

      Please prove you are human by selecting the heart.

      CooperFix services commercial refrigeration equipment only.
